Skip to main content

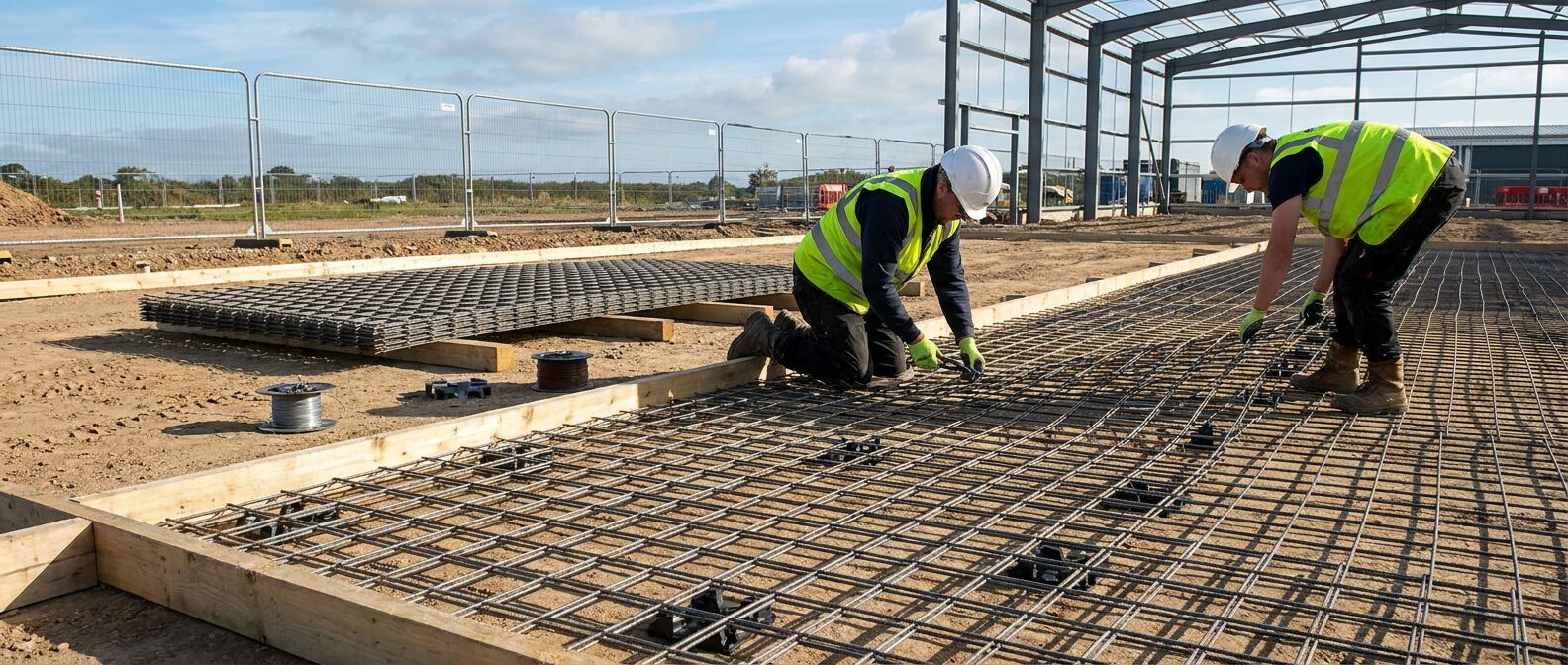

Steel fixers laying welded reinforcement mesh on spacers before a UK industrial floor slab pour

Reinforcement mesh take-off calculator

Estimate whole reinforcement mesh sheets, total purchased sheet area and delivery weight. Enter the sheet overlaps from the structural drawings so the layout reflects the project, not a generic rule.

Updated

Share

A take-off is a quantity estimate prepared before ordering. A lap is the overlap between adjacent mesh sheets, while welded reinforcement fabric is the formal term used for factory-made reinforcement mesh.

Take-off checker, not structural design

Use the mesh designation, layers, orientation and lap dimensions stated on the engineer's drawings. This tool estimates full sheets and weight. It does not select reinforcement or decide lap lengths.

Mesh sheet calculator

A full-sheet grid is calculated across a rectangular slab. The result is conservative because it does not assume that every cut-off can be reused elsewhere.

Overlap measured along the sheet length.

Overlap measured across the sheet width.

Sheet orientation from drawing

For B and C meshes, confirm the main reinforcement direction. The lowest sheet count is not a reason to rotate structural mesh.

How the sheet count is calculated

Each direction is treated as a row of overlapping sheets. Once the first sheet is placed, every additional sheet contributes its full dimension minus the stated lap.

Stock sheet

4.8m x 2.4m

The standard stock sheet area is 11.52 m². CARES publishes the table weight for this size.

Merchant sheet

3.6m x 2.0m

The standard merchant sheet area is 7.2 m². Its weight is calculated from the BS 4483 mass per square metre.

Formula used in each direction

1 + ceiling((required span - sheet span) / (sheet span - lap)), with one sheet where the required span already fits inside a single sheet.

Total grid sheets = sheets along the slab x sheets across the slab x layers. The order quantity then applies the optional extra allowance and rounds up to a whole sheet.

BS 4483 mesh weights

The selected mesh is highlighted. Figures are from the 2025 CARES guide table based on BS 4483:2025. Longitudinal means the main direction used in the designation, not simply whichever sheet edge looks longer.

Mesh Longitudinal wires Transverse wires Mass Stock sheet
A39310mm at 200mm10mm at 200mm6.16 kg/m²71.08 kg
A2528mm at 200mm8mm at 200mm3.95 kg/m²45.50 kg
A1937mm at 200mm7mm at 200mm3.02 kg/m²34.79 kg
A1426mm at 200mm6mm at 200mm2.22 kg/m²25.57 kg
B113112mm at 100mm8mm at 200mm10.90 kg/m²125.05 kg
B78510mm at 100mm8mm at 200mm8.14 kg/m²93.83 kg
B5038mm at 100mm8mm at 200mm5.93 kg/m²68.26 kg
B3857mm at 100mm7mm at 200mm4.53 kg/m²52.19 kg
B2836mm at 100mm7mm at 200mm3.73 kg/m²42.97 kg
C78510mm at 100mm6mm at 400mm6.72 kg/m²77.47 kg
C6369mm at 100mm6mm at 400mm5.55 kg/m²63.88 kg
C5038mm at 100mm5mm at 400mm4.34 kg/m²51.90 kg
C3857mm at 100mm5mm at 400mm3.41 kg/m²41.18 kg
C2836mm at 100mm5mm at 400mm2.61 kg/m²32.97 kg
D492.5mm at 100mm2.5mm at 100mm0.77 kg/m²8.97 kg

Table weights use the 4.8m x 2.4m stock sheet. Merchant sheet weight is calculated from the published mass per square metre.

What the mesh letters mean

The selected family is highlighted. The letter describes the wire arrangement, not the slab application on its own.

A: square mesh

The same wire diameter and 200mm pitch in both directions. CARES describes this as the most widely used family.

B: structural mesh

More reinforcement in the longitudinal direction. Its orientation must follow the structural drawings.

C: long mesh

Main reinforcement in one direction. CARES notes that C fabrics are not normally held as stock and may need special ordering.

D: wrapping mesh

Light wire fabric used mainly for wrapping, fire protection and links rather than as a general slab mesh.

Laps, cover and support

A lap is the overlap between adjacent sheets that allows reinforcement continuity. It is a structural detail, so the calculator deliberately has no recommended default.

Take both lap directions from the drawing

End and side laps can differ, especially for B and C meshes. Entering one generic overlap in both directions can change sheet count and, more importantly, may not match the design.

Support mesh at the designed level

Concrete cover is the distance from the concrete face to the nearest steel. Mesh needs suitable spacers or chairs so it stays at the specified level during the pour.

Plan cuts before ordering

This full-sheet grid does not reuse cut-offs. A marked layout can reduce waste where an off-cut from one bay fits another, but every reused piece still needs the specified laps and orientation.

Delivery and handling checks

  • CARES says welded fabric bundles are normally about 1.5 tonnes and must be lifted with suitable slings, not by the bundle ties.
  • Confirm the delivery vehicle, lifting plan, set-down area and ground bearing capacity before the load arrives.
  • Complete a delivery and handling risk assessment, agree a safe system of work and follow the supplier's handling instructions.
  • Check the supplier's certification, mesh designation, grade and quantity against the schedule before fixing starts.

Sources

Both links were checked on 30 August 2026. The CARES table is reproduced for take-off use; project drawings and the supplier's schedule remain the controlling information.
